22 February, 2016

22.02.16 (publicholiday)


Turbine Hall View West side
 Turbine Hall View East side

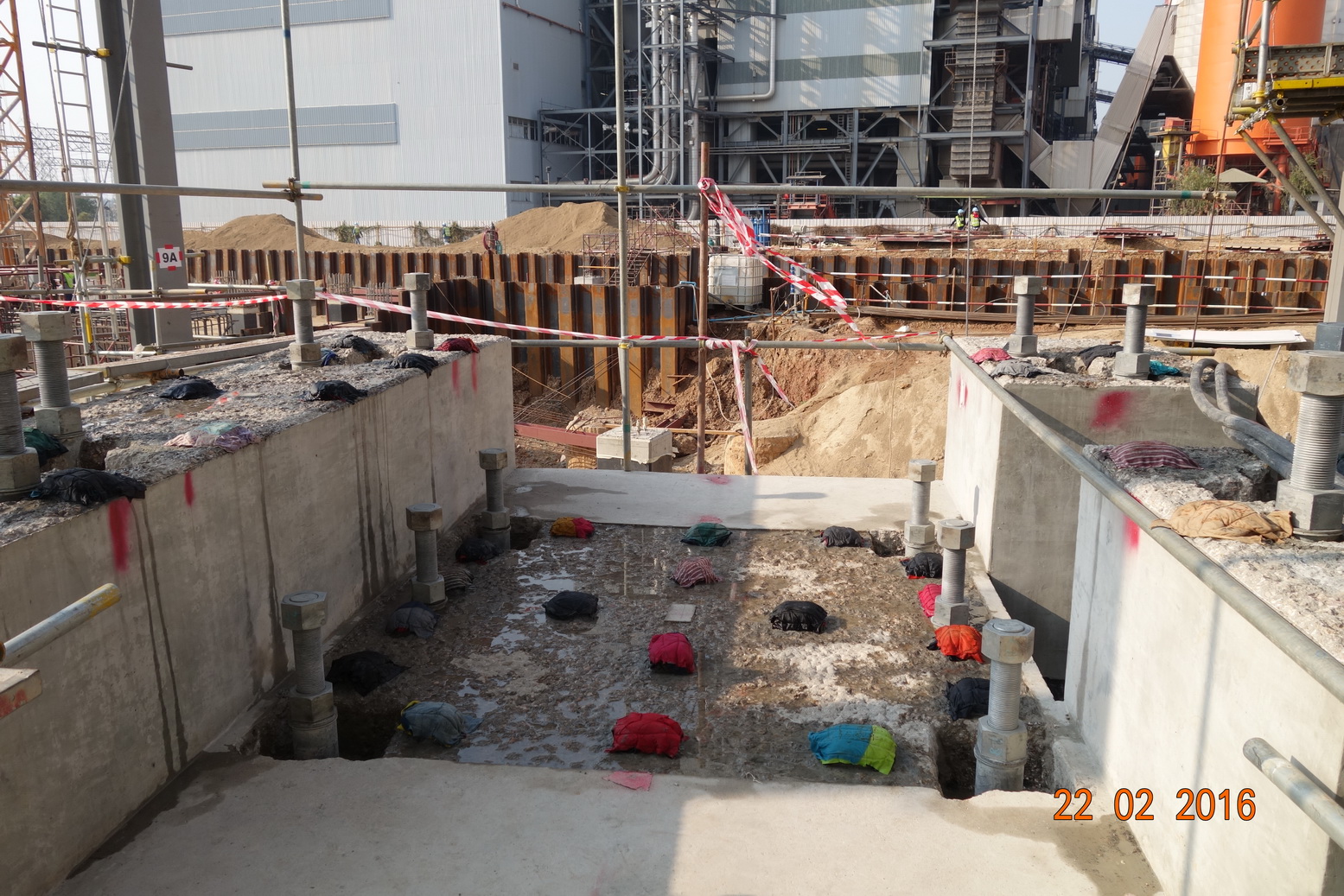

 Cooling Water pipes backfilling North of Turbine Hall
 Cooling water Pipes Intake to Turbine Hall
 CEB excavation and Pile cutting for CEB handover
 Boiler steel erection, Mills Bay, Tier #2
  Boiler steel erection, Mills Bay, Tier #2
  Boiler steel erection, Eats side & air preheater area
 Boiler Mill#A, packer plates installation for sole plates
 Boiler PA Fan progress, North side
 Boiler PA Fan progress, South side
 Boiler FD Fan, south side
 Cooling Tower, raft rebar progress
 Stack, slipform, started on 20th Feb @ 13h45 (1,4 m/ 12 m shift)
 Boiler material delivery: First mills
  Boiler material delivery: First mills
 Boiler material delivery: Mills part
